NE Big Rock Road Overlay Project
Contractor crews working for King County completed paving and fully reopened NE Big Rock Road on Nov. 9, 2026.

This project was part of King County's 2026 Road Resurfacing Program. Resurfacing helps extend the life of county roads, reduce long-term maintenance costs, and provide a smoother, safer ride with fewer potholes and bumps for travelers.
Status update
November 20, 2026
Contractor crews working for King County Road Services completed paving along 3.23 miles of NE Big Rock Road, between the Duvall city limits and Kelly Road NE, on November 9, 2026. The road is now fully open to all traffic.
Project overview
Road Services paved 3.23 miles of NE Big Rock Road between the Duvall city limits and Kelly Road NE. This rural two-lane road was in poor condition and ready for fresh pavement. There are two sections of this roadway that were previously treated with High Friction Surface Treatment and will not be paved as part of this project. There were also some additional spot repairs in three locations and some prep work along the road shoulder. Crews painted permanent striping after the new roadway cured.
CONTACT
Christina Lorella, Communications
Email: clorella@kingcounty.gov
Phone: (206) 477-5771
24/7 Road Helpline

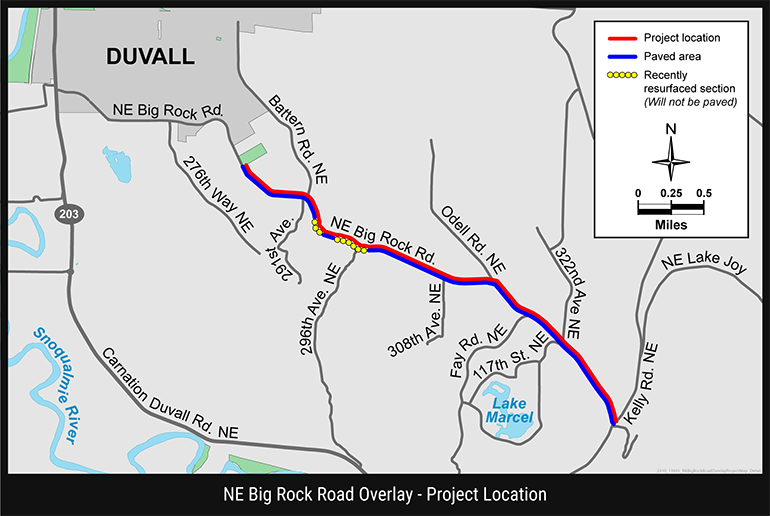

Project location map

What is paving overlay?
An overlay, also known as a topcoat or resurfacing, is a process where a new layer of asphalt is applied in the same location as an existing paved surface. This technique is typically used when the existing pavement has minor damage like cracking or potholes, but the underlying base is still structurally sound.
Paving overlay process:
- Crews used machines to grind and remove over two inches of existing pavement. This created a clean and uniform surface at the proper depth for the new pavement.
- The roadway was cleaned of loose debris, dirt, and any other loose or damaged materials to make sure the surface of the road was prepped for the new top layer.
- Repairs were made to any problems in the subsurface of the road.
- A thin layer of bonding agent, called tack coat, was applied to the prepared surface to create a strong adhesive bond between the old and new layers of asphalt.
- Specialized equipment spread the new hot-mix asphalt over the tack-coated surface.
- Rollers were used to compact the newly laid asphalt to keep the surface of the road smooth, durable, and uniform.
- Once the new asphalt cooled and set, crews installed temporary traffic markings and lane striping.
- Permanent traffic markings and lane striping were installed after paving, once the new road surface had time to cure.
Project budget
The total budget including design, construction, and construction management for this project was $2.2 million and was funded through the Puget Sound Regional Council and King County local fund.
Project timeline
- Design complete: Summer 2025
- Construction began: September 21, 2026
- Construction complete: November 9, 2026
Frequently Asked Questions
What is the average daily traffic on NE Big Rock Road?
On average, 3,100 vehicles travel on NE Big Rock Road each day.
Photos

October 8, 2026: Crews working for King County install yellow reflective tape on NE Big Rock Road to temporarily separate traffic lanes and guide drivers safely through the work zone. Once the new pavement has cured, crews will return to install permanent pavement markings.

October 6, 2026: Crews working for King County repaving a section of westbound NE Big Rock Road.

October 2, 2026: Crews repair the existing roadway before applying a tack coat, an adhesive that helps new asphalt bond to the pavement below.

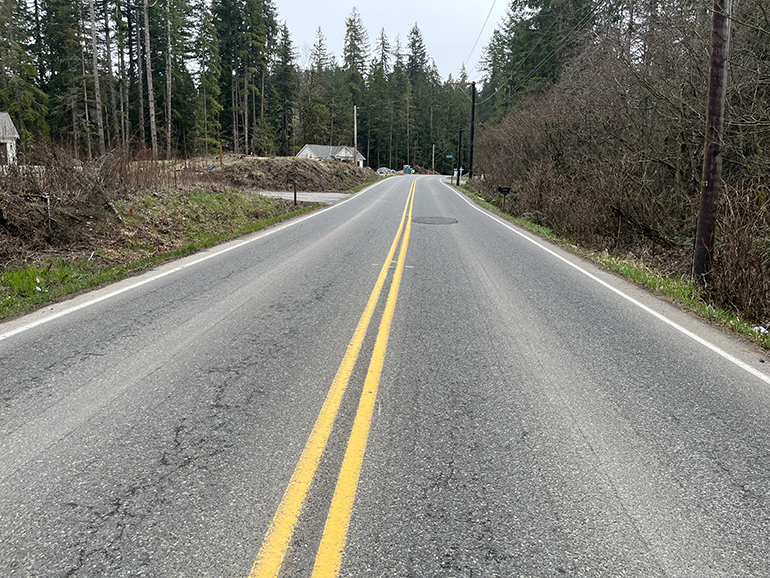

3.23 miles of NE Big Rock Road will be paved between the Duvall City Limits and Kelly Road NE in fall 2026. The current surface is cracked and potholed and is ready to be repaved.

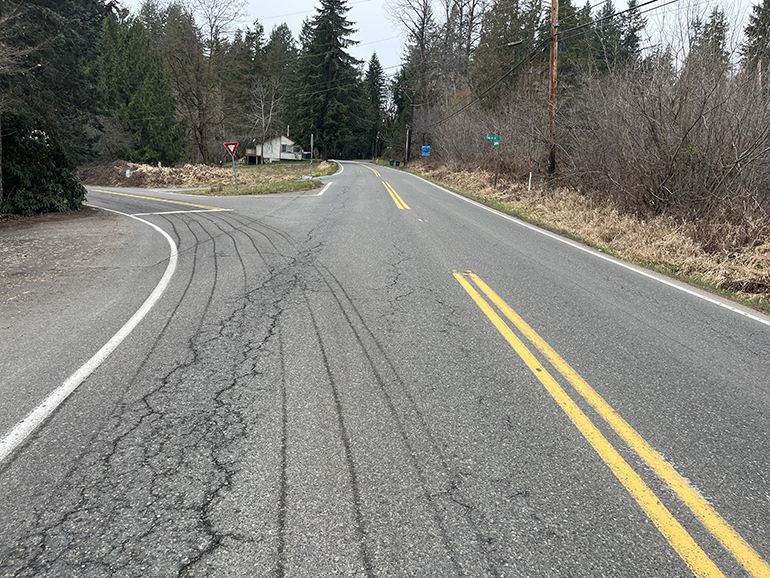

This photo, taken between 117th Street NE and Kelly Road NE, shows cracking in the pavement and patching over potholes.
