244th Avenue NE Slide Repair Project

Project completed in summer 2024

August 31, 2024 - 244th Ave NE is now ready for travelers with a fresh layer of pavement and temporary striping. Beyond the newly installed guardrail along the north side of the road, the replacement retaining wall provides stronger, improved support for the hillside.

Status update

September 2024

Both directions of 244th Ave NE re-opened to traffic at 8:30 a.m. Saturday, Aug. 31.

Crews will return to the project location on September 19th, 23rd, and 24th from 9 a.m. to 3 p.m. each day. Travelers can expect delays while crews reduce traffic and flaggers alternate two-way traffic. The team will be adding final lane striping, fencing, building curbs, and painting the new retaining wall. Please check this website or MyCommute for more information. This work is weather dependent and can be rescheduled.

24/7 Road Helpline

24/7 Road Helpline

Call us for help at 206-477-8100 or 1-800-527-6237 with road maintenance and traffic safety issues in unincorporated King County — 24 hours a day

Overview

This project replaced a damaged 90-foot-long retainment wall located below the north side of 244th Avenue NE near Redmond Fall City Road (State Route 202). The previous support wall suffered slide damage in winter 2020 and could not reliably support the edge of the roadway.

In February 2020, King County Road Services temporarily placed a barrier next to the damaged section of wall and moved both travel lanes over. The barrier and lane shift were put in place as a safety precaution to help prevent the road from damage and to stop the wall from shifting further.

The County closed a section of 244th Avenue NE for eight (8) weeks to complete the repair. Crews dug a nine (9)-foot-deep pit across both lanes of traffic to remove and replace the damaged 90-foot-long retainment wall, then replace the soil under the roadway with more stable soil.

The County filled the pit with dense, compact soil and repave the road at the end of the project. This, along with the new retaining wall will help prevent the road from sliding again.

The roadway returned to the full width in late summer 2024.

Location map

The project is located on the west side (southbound) of 244th Avenue NE, adjacent to the city of Sammamish.



Larger view (277KB)

Project timeline

  • Environmental review: Spring 2022
  • Construction and road closure begins: Mid-July 2024
  • Road reopens to traffic: Late August 2024
  • Construction ends: September/October 2024

Project budget

The estimated total project budget is $3.7M. This project is funded through Federal and local county funds.

Frequently asked questions

The slide repair work required crews to dig a nine (9)-foot-deep pit across both lanes of traffic to remove and replace the badly damaged 90-foot-long retainment wall and replace the soil under the roadway with more stable soil that won’t slide in the future.

Initially, we believed we could replace the retaining wall without digging up the road. But analysis by County engineers show that the heavy construction equipment needed to repair the wall could make the road slide more. This is because the soil under the road wasn't packed tightly enough, and the hillside wasn't stable enough to handle the extra pressure and weight of the construction equipment.

The County filedl the pit with dense, compact soil and repave the road at the end of the project. This, along with the new retaining wall will help prevent the road from sliding again.

The road was damaged in early 2020, and it a took a few years to design the repair plans. We had initially planned to do the project in summer 2023, however more time was needed to acquire the necessary construction materials. The project could also only happen during the summer months when school is not in session, as the road is a busy school bus route. These factors led us to reschedule the work for summer 2024. King County is committed to completing construction on this bus route before the start of the public-school year in September.

Photos

Crews using a drum roller compactor.

August 2024 – Crews use a drum roller compactor to compact a layer of subbase material. This is a critical step that will allow the road the support heavy volumes of traffic on the pavement above.



Crews are grading the new road in preparation for paving.

August 2024 – A dumper truck hauls the final load of backfilling material to the project site. This material was used to refill and provide support to the area that was excavated on 244th Ave NE.

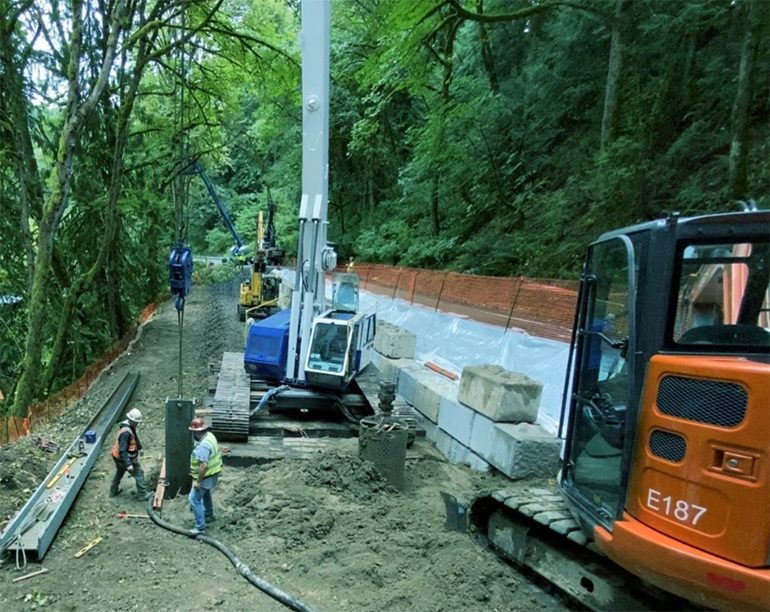

Workers place a steel beam, known as a "soldier pile," deep into the ground. This beam helps keep the ground stable and stops the soil from moving around.   July

July 2024 – Workers place a steel beam, known as a "soldier pile," deep into the ground. This beam helps keep the ground stable and stops the soil from moving around.



A large drill, called an auger, drills into the soil on 244th Ave NE to prepare for the new steel soldier piles.

July 2024 – A large drill, called an auger, drills into the soil on 244th Ave NE to prepare for the new steel soldier piles.

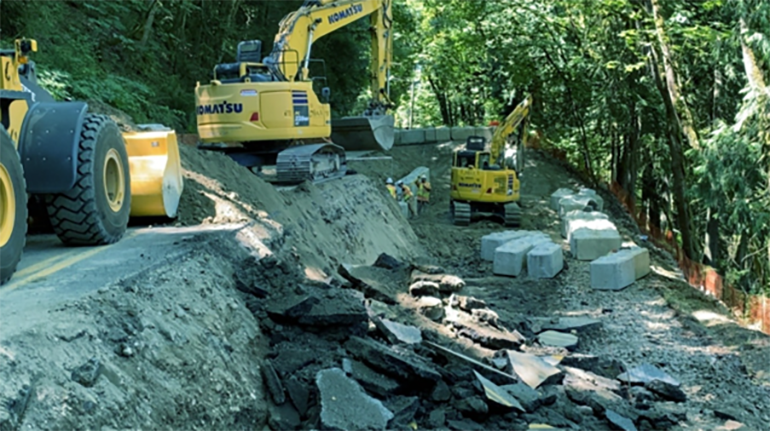

Excavated unstable soil is removed below the road to prepare for solider pile installation.

July 2024 – Excavated unstable soil is removed below the road to prepare for solider pile installation.



A tractor scrapes away old unstable soil and compacts the base using rocks to build a better base for construction.

July 2024 – The tractor scrapes away old unstable soil and compacts the base using rocks to build a better base for construction.



An orange barrier next to the damaged section of wall and narrowed the travel lanes.

Looking north: King County Road Services temporarily placed a barrier next to the damaged section of wall and narrowed the travel lanes in February 2020. Photo taken in February 2024.



Looking southbound on 244th Avenue NE.

Looking south: This is the view heading southbound on 244th Avenue NE. The damaged gabion wall is located below the shoulder, to the right of the guardrail.



Before and after photo of damaged asphalt caused by significant ice followed by rain during the recent winter storm.

Road maintenance crews continuously monitor the road for damage and to make sure the support wall has not shifted further. For example, crews repaired a large, cracked section of 244th Avenue NE on January 19, 2022. The damaged asphalt was caused by significant ice followed by rain during the recent winter storm.
